How Much Does It Cost to Install a Commercial EV Charger in Mesa, AZ?

Mesa EV Chargers quotes commercial installations in Mesa after checking panel capacity and the route to your parking spaces, because electrical infrastructure can cost more than the charger itself. Level 2 installations typically run $3,500-$15,000 per port. DC fast-charging equipment ranges from $80,000 to $250,000 or more per unit before site work and utility coordination.

Quick Summary

  • Level 2 commercial charging typically costs $3,500-$15,000 installed per port, including hardware and electrical labor.
  • DC fast chargers typically cost $80,000-$250,000+ per unit before site work and utility coordination; confirm those additional costs in the quote.
  • A panel upgrade, when needed, typically adds $2,000-$8,000 depending on existing capacity and the required service size.
  • Trenching, conduit distance, parking modifications, permit review, and utility work all affect the final scope and schedule.

What Drives Commercial Charging Costs

Choose the Charging Level

Commercial Level 2 units commonly draw 30-80 amps. DC fast chargers in the 150-350 kW range often need three-phase service and a dedicated transformer, putting them in a different infrastructure category.

Trace the Electrical Route

The route from the electrical room to the parking space affects conduit, conductor, and trenching work. Long underground runs or asphalt excavation can make a modest charger a much larger project.

Get an Itemized Site Quote

A useful quote follows a panel load calculation and parking layout review. Confirm the charger, dedicated circuit, site work, and any service upgrade in the written scope before approving installation.

Commercial Charging Site Checks

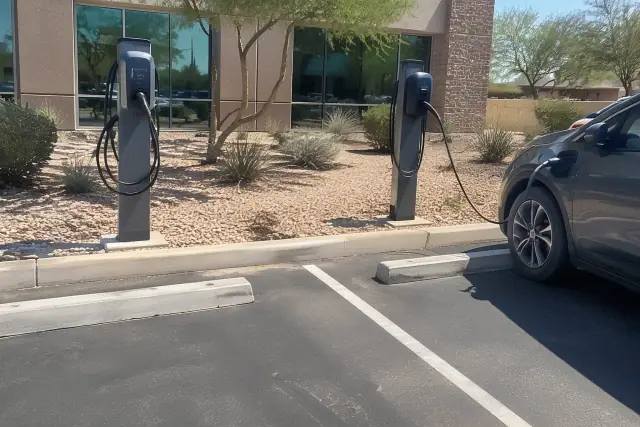

Level 2 EV Charger Beside an Office Parking Space

Level 2 EV charger installed in an office parking lot in Mesa, AZ.

An office parking space near the electrical room helps illustrate a simpler Level 2 installation. Available panel capacity and the conduit route determine how much electrical work it needs.

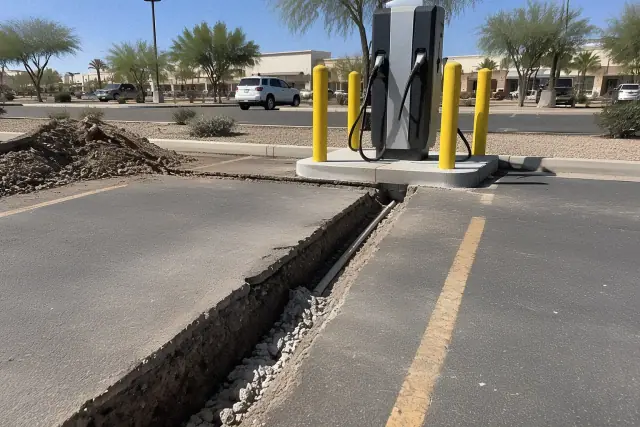

EV Charger Conduit Trench Across an Asphalt Lot

EV charger conduit trench cut across an asphalt parking lot in Mesa, AZ.

A trench across an existing parking lot shows why charger hardware is only part of the budget. The quote should account for excavation and the route of underground electrical work.

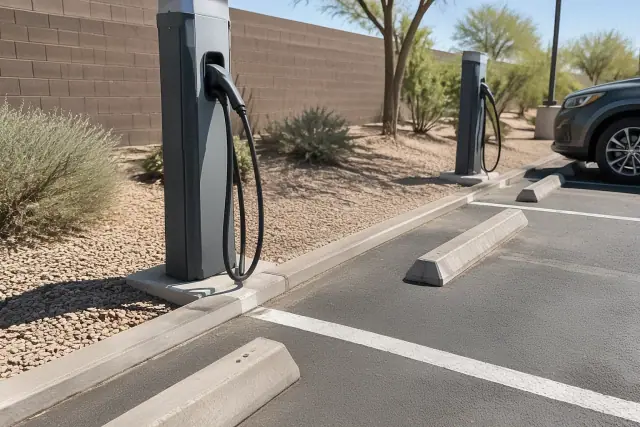

EV Charger Panel Capacity and Parking Layout Review

Dual EV charging pedestals and painted parking stalls in a Mesa, AZ employee lot.

Reviewing the panel and proposed charging spaces together connects the electrical load calculation to the parking layout. This helps identify service upgrades and access requirements before quoting.

Installation Schedule Snapshot

Single Port, Adequate Capacity

A straightforward Level 2 installation with enough panel capacity can often be completed in one to three days. Confirm permit timing separately from the installation work.

Trenching and Utility Work

Larger installations involving trenching, utility coordination, or three-phase service typically take four to eight weeks once permits and utility scheduling are included.

Service Upgrade Review

An older 100- or 150-amp panel may need an upgrade to 200-400 amp service for multiple ports and the existing building load. The load calculation determines whether an upgrade is necessary.

Written Scope Before Approval

Compare quotes for the same work: charging ports, circuits, trenching, bollards, striping, and accessible parking modifications. An equipment-only price does not describe a completed charging site.

Commercial EV Charger Cost Comparison

Commercial Charging Equipment and Electrical Work

Project scopeTypical price rangeWhat the range covers or depends on
Commercial Level 2 port$3,500-$15,000 per port installedCharger hardware and electrical labor; panel capacity, conduit distance, and trenching affect the final scope.
Single office Level 2 port$4,500-$12,000 installedAn office charging installation; electrical room distance and available capacity influence the price.
DC fast charger (Level 3)$80,000-$250,000+ per unit before site work and utility coordinationPower output drives equipment cost; confirm trenching, switchgear, transformer, and utility work separately.
Panel or service upgrade$2,000-$8,000 when neededExisting service size and the capacity required for charging and building loads determine the work.
NEMA 14-50 outlet installation$1,200-$2,000 per outlet installationPhoenix East Valley outlet work; run length, panel distance, and routing through stucco, block, or slab affect cost.

The office-port range is a specific Level 2 installation scope. Panel upgrades and outlet work are separate scopes to check against your quote, not amounts to add automatically to every port.

What an Installed Price Includes

An installed commercial charging price brings together the charger, electrical infrastructure, and parking lot work. A retail property along Power Road, a downtown Mesa office building, and a warehouse lot near the Fiesta District can require different conduit routes and parking changes. Hardwired installation costs depend on wire gauge, conduit type, and whether conductors run through exposed EMT conduit or finished walls. Desert heat also matters when selecting outdoor equipment and materials. Ask how the written scope handles City of Mesa Building Safety Division permit review, Salt River Project service coordination where needed, and accessible parking modifications such as access aisles and van-accessible spacing.

Fleet and Multifamily Operating Costs

Fleet charging costs scale with vehicle count and site capacity, while multifamily properties may use shared Level 2 ports with usage metered per unit or parking space. Fleet programs report fuel savings of roughly $1,032 per vehicle annually, but savings depend on operating costs. A $120,000-$200,000 cumulative savings figure for a 20-vehicle fleet needs a defined time horizon before it can establish a payback period. Electricity rates, utility demand charges, and charging fees also belong in the operating budget; installation price alone cannot show the full financial outcome.

Common Follow-Up Questions

Do I need an electrical upgrade? A single Level 2 port may fit the existing service if the load calculation shows enough spare capacity; multiple ports or DC fast charging can require more infrastructure. What breaker size is needed? Many commercial Level 2 units use a 40-100 amp dedicated breaker; the NEC Article 625 continuous-load sizing relationship is 125% of charging current, or 80% circuit loading, so a 48-amp charger calls for a 60-amp breaker and appropriately sized conductors. What does charging cost afterward? The electricity tariff, demand charges, and any per-kWh fee set by the property determine ongoing cost. Can existing wiring reduce replacement costs? Reusable wiring and adequate panel capacity can make a replacement less involved than rebuilding the electrical supply.
